Sleipnir's first project makes waves with record-breaking 15,300 metric ton lift

Offshore transport and installation

Leviathan Project

Thialf and Sleipnir install the Leviathan Production Platform over two phases for client Noble Energy

See our response

At a glance

  • Transport and installation of the jacket and topsides for the Leviathan Production Platform
  • Jacket launch and installation with Thialf in February 2019
  • Topside installation with Sleipnir in September 2019
  • Topside weighing a combined 30,000 metric tons
  • Record-breaking 15,300 metric ton lift
  • Zero recordable HSE cases

The Heerema promise

Sustainability
Sustainability

As a carbon-neutral contractor you can trust Heerema to create sustainable value on your project.

Team onboard Aegir Greater Changhua project
Safety

We have the highest standards of safety and believe in an incident and injury-free workplace. To achieve this goal we follow our Dare to Care program.

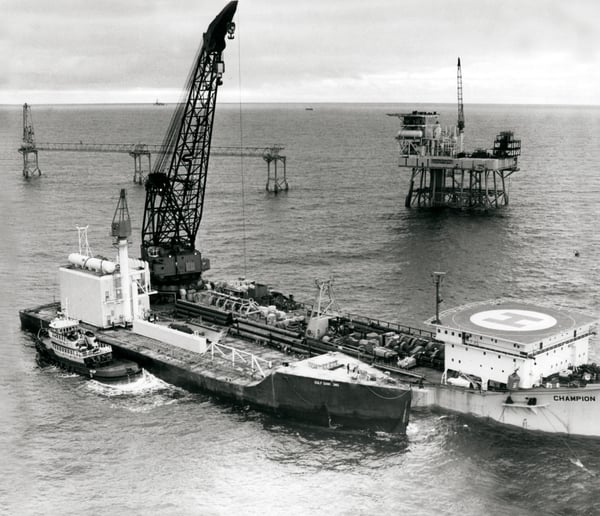

Champion bij Ekofisk 1973
Reliability

With over fifty years of experience in transporting, installing, and removing offshore infrastructure you can rely on Heerema.

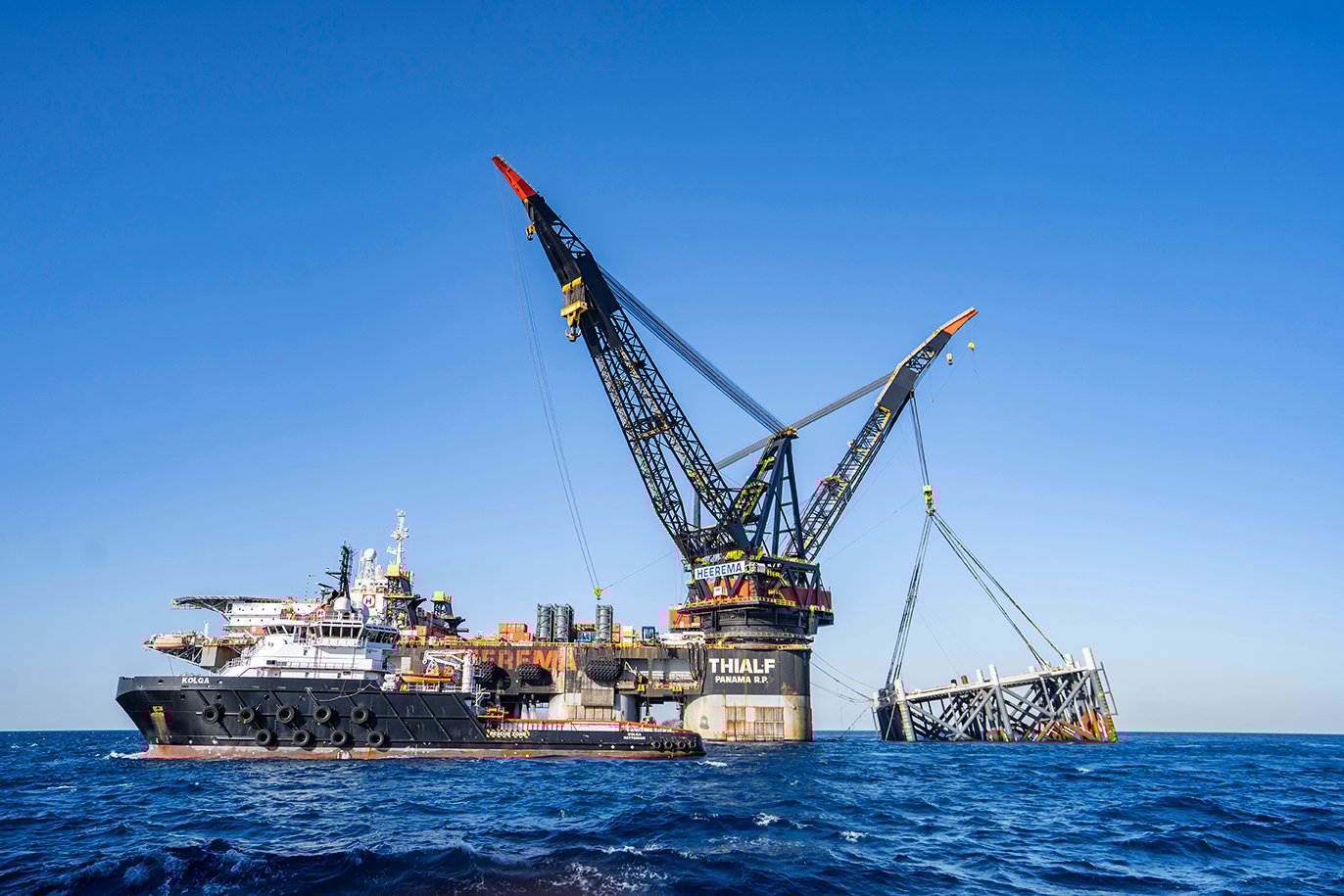

Thialf jacket installation Leviathan (1) Low Res
Thialf jacket installation Leviathan (2) Low Res
Thialf jacket installation Leviathan (3) Low Res
Thialf jacket installation Leviathan (5) Low Res
Sleipnir installing Leviathan platform (1) Low Res
Sleipnir installing Leviathan platform (2) Low Res
Sleipnir installing Leviathan platform (3) Low Res
Sleipnir installing Leviathan platform (5) Low Res

Phase 1: Thialf installing the jacket

Thialf installed the 15,200 metric ton jacket in February 2019

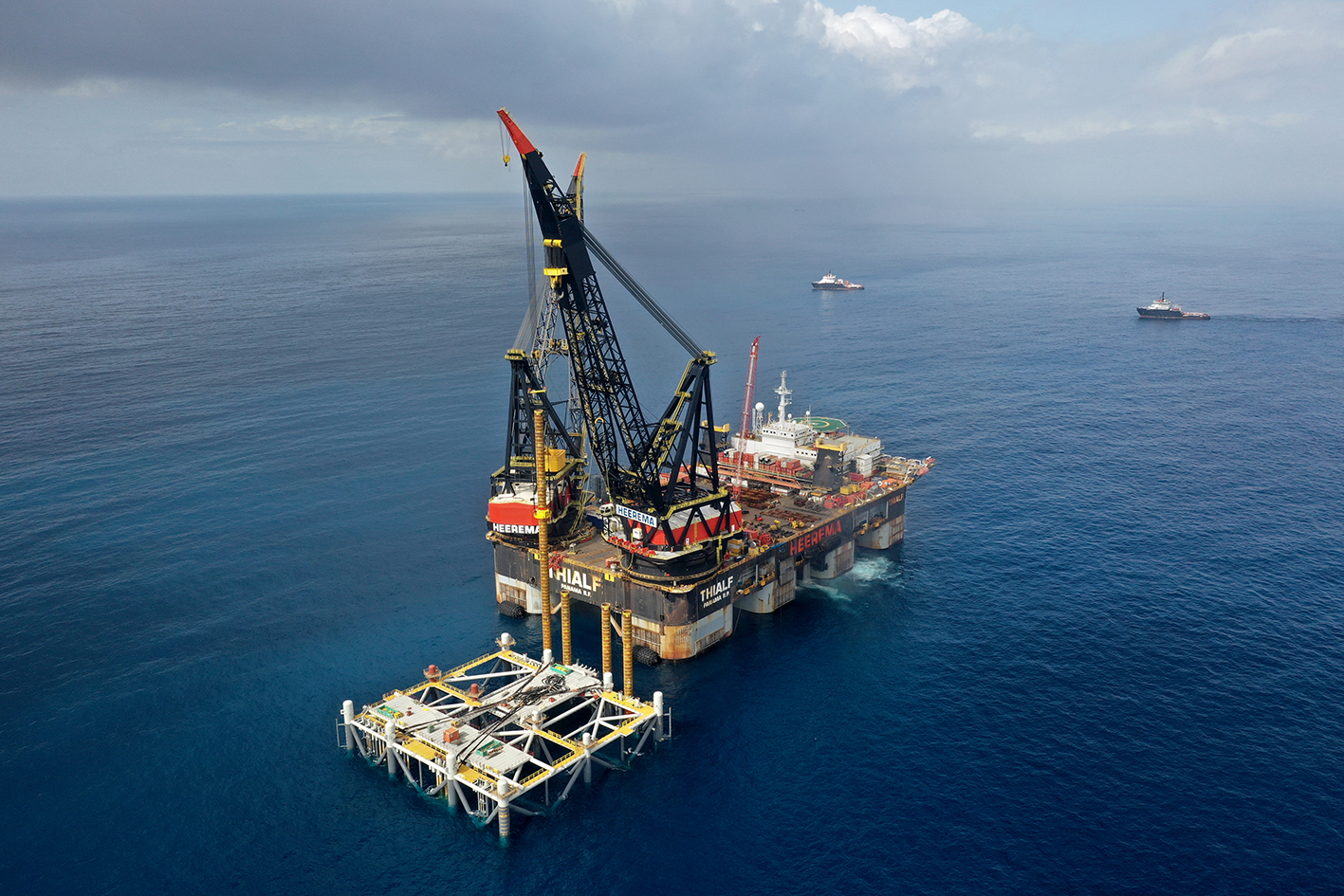

Phase 1: Thialf installing the jacket

During the installation of the jacket, Thialf was assisted by Kolga and Bylgia

Phase 1: Thialf installing the jacket

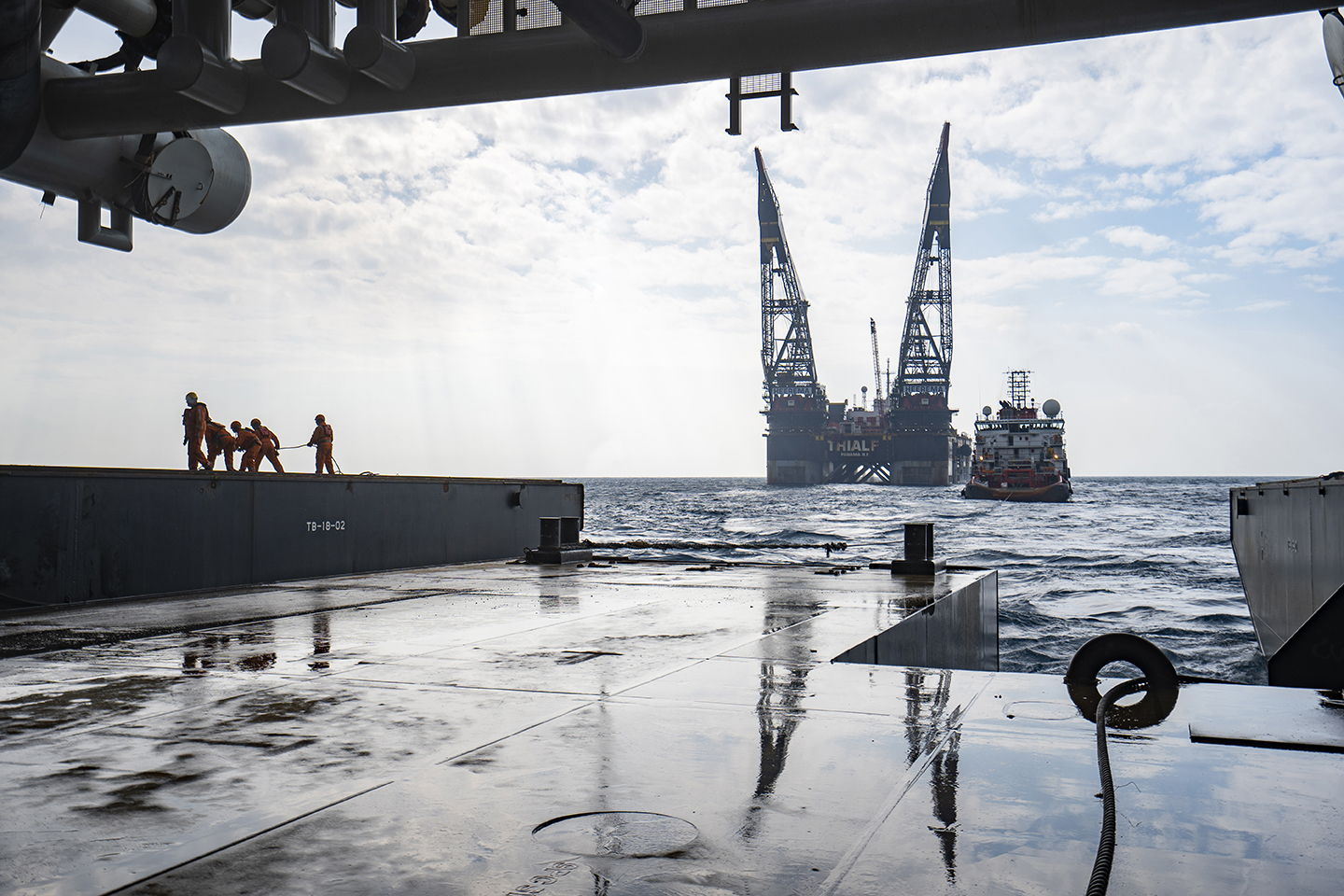

Phase 1: View from barge

The view from the barge carrying the jacket, approaching Thialf

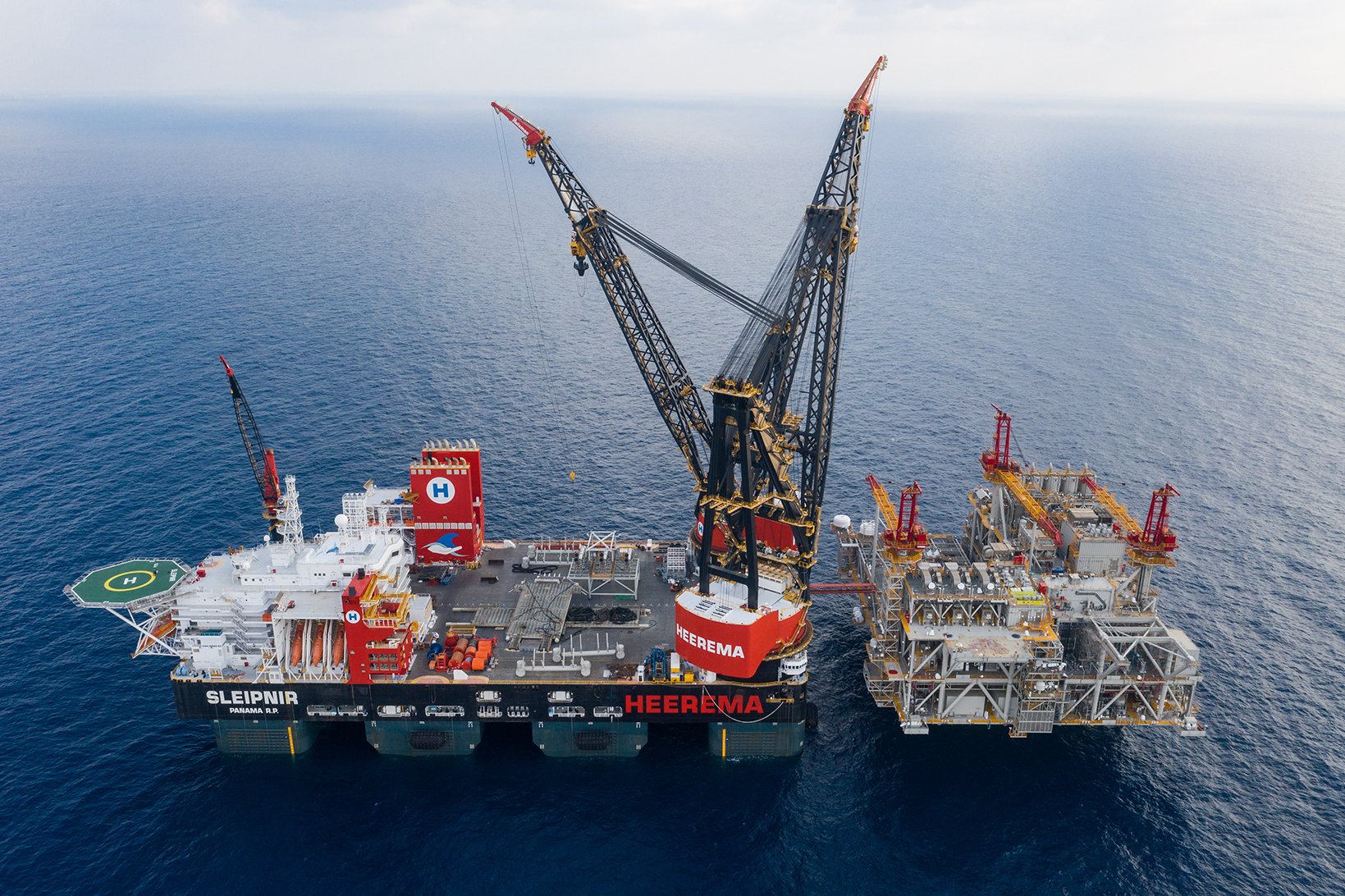

Phase 2: Sleipnir installing topside

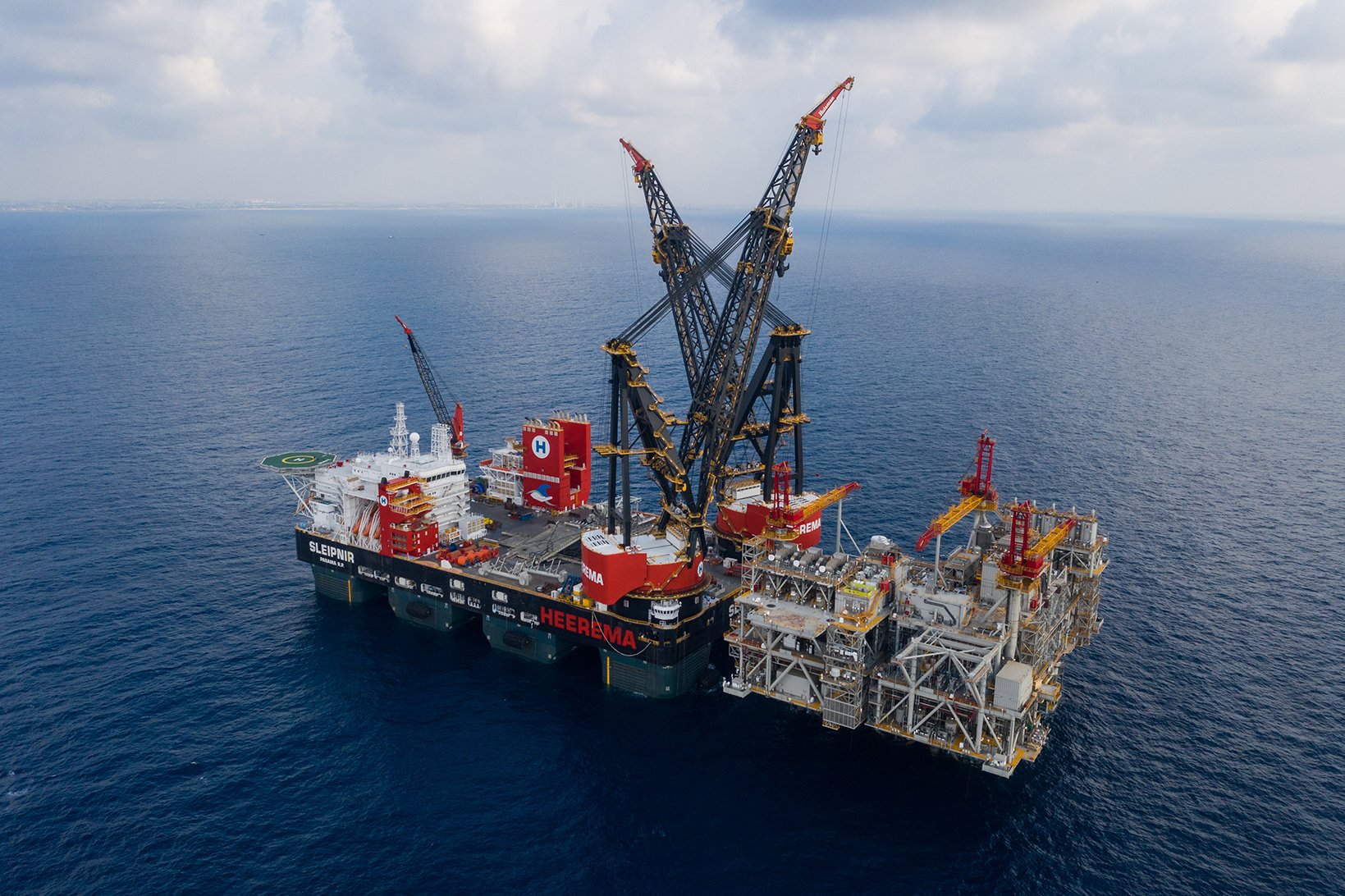

Phase 2: Sleipnir installing topside

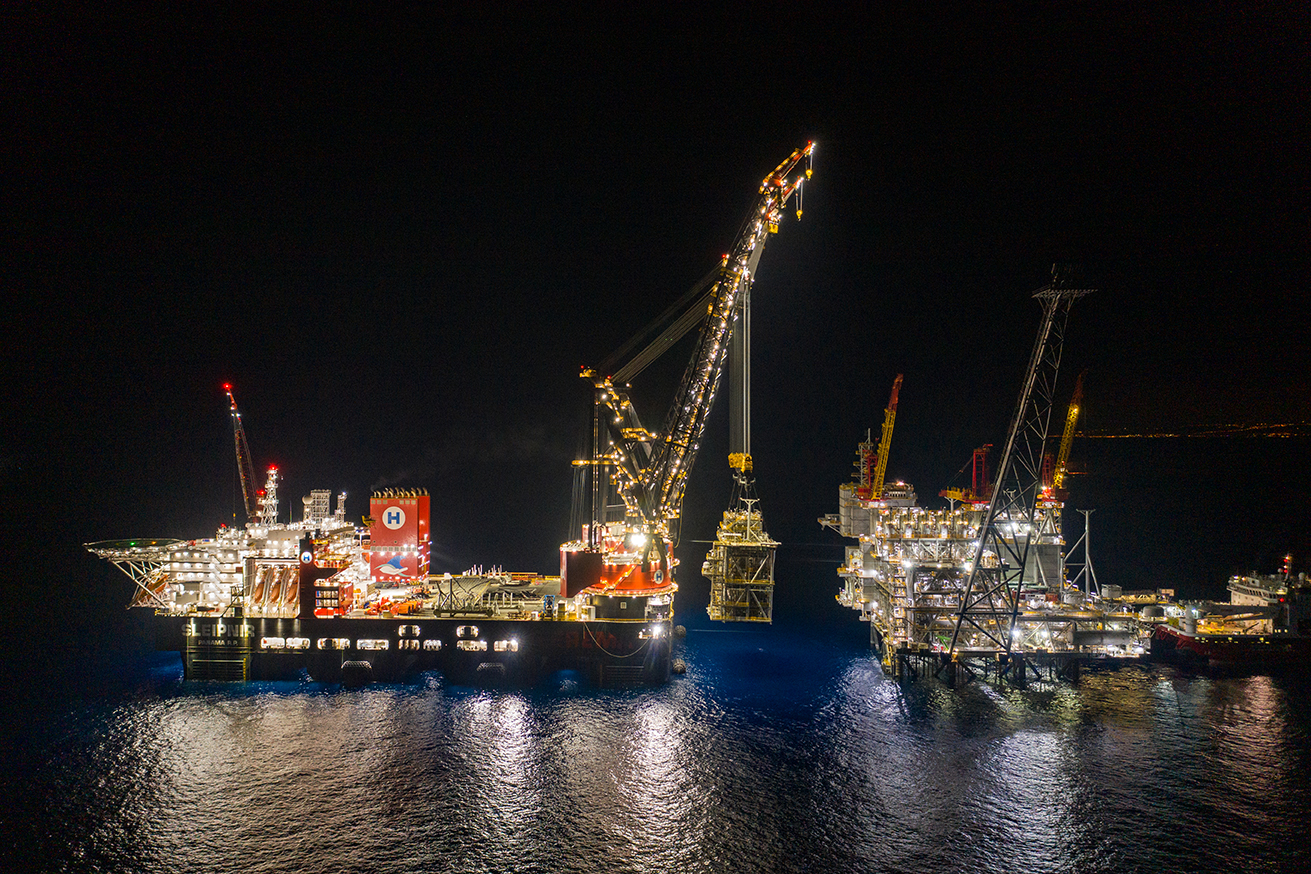

Phase 2: Sleipnir installing topside
Phase 2: Sleipnir installing topside
Thialf jacket installation Leviathan (1) Low Res Thialf jacket installation Leviathan (2) Low Res Thialf jacket installation Leviathan (3) Low Res Thialf jacket installation Leviathan (5) Low Res Sleipnir installing Leviathan platform (1) Low Res Sleipnir installing Leviathan platform (2) Low Res Sleipnir installing Leviathan platform (3) Low Res Sleipnir installing Leviathan platform (5) Low Res

Installing the Leviathan Production Platform

Heerema’s scope was to transport and install the Leviathan Production Platform topsides and jacket on behalf of client Noble Energy. The project was split over two campaigns, with Thialf firstly installing the 15,200 metric ton launch jacket in February, 2019. This jacket installation was later followed by the transport and installation of the 9,200 and 15,300 metric ton topsides, executed by Sleipnir in September, 2019.

Leviathan Development

The Leviathan Production Platform (LPP) will develop the Leviathan Field, which holds 33 Tcf of natural gas resources in place (22 Tcf recoverable) and is one of the largest natural gas finds in the world in the last decade. The LPP is located approximately 125 km west of Haifa in the Eastern Mediterranean Levantine Basin.

Phase 1 - Thialf jacket installation

On February 13, 2019, Thialf successfully installed the 15,200 metric ton Leviathan Production Platform jacket. The jacket was launched using the Heerema H-591 barge before being upended and set down by Thialf.

The quality planning and detailed engineering coupled with the transport and offshore execution campaigns resulted in an outstanding outcome for Noble's Leviathan Project.

Phase 2 - Sleipnir topsides installation

Sleipnir arrived on location in the Leviathan Field on September 5, and started the topsides installation on September 7, 2019. The vessel’s first lift was the record-breaking 15,300 metric ton Domestic Supply Module. This module was followed by the 9,200 metric ton Liquids Supply Module, as well as several smaller components including the ventboom, 100 persons living quarters, and the observation tower. The combined weight totalled 30,000 metric tons installed.

The DSM (15,300MT) and LSM (9,200MT) modules were installed within twenty hours, and this fast execution time was the primary motivation for Noble Energy to contract Sleipnir for installation.

The project was executed within the time frame scheduled, and had zero reportable HSE cases.

As always, Heerema's commitment to provide operational excellence can be seen throughout this project.

George Hatfield - VP of Major Projects Noble Energy

Key information

Milestones

Contract signed: Aril 20, 2017

Offshore start:
Phase 1: January 25, 2019
Phase 2: September 5, 2019

Offshore end:
Phase 1: February 13, 2019
Phase 2: September 17, 2019

Main spread

Sleipnir
Thialf
Kolga
Bylgia

Phase 1:
Barge H-591; H-542

Phase 2:
Barge H-591; H-627; H-406; H-407

Main technical data

Phase l: Thialf

Jacket weight: 15,500 mT

Phase ll: Sleipnir

DSM weight: 15,300 mT
LSM weight: 9,220 mT
LWM weight: 2,120 mT
MRU weight: 2,451 mT
Ventboom weight: 632 mT

Need a specific answer? Let us help.

Michiel Pors
Michiel Pors

Commercial Manager T&I

Get in touch

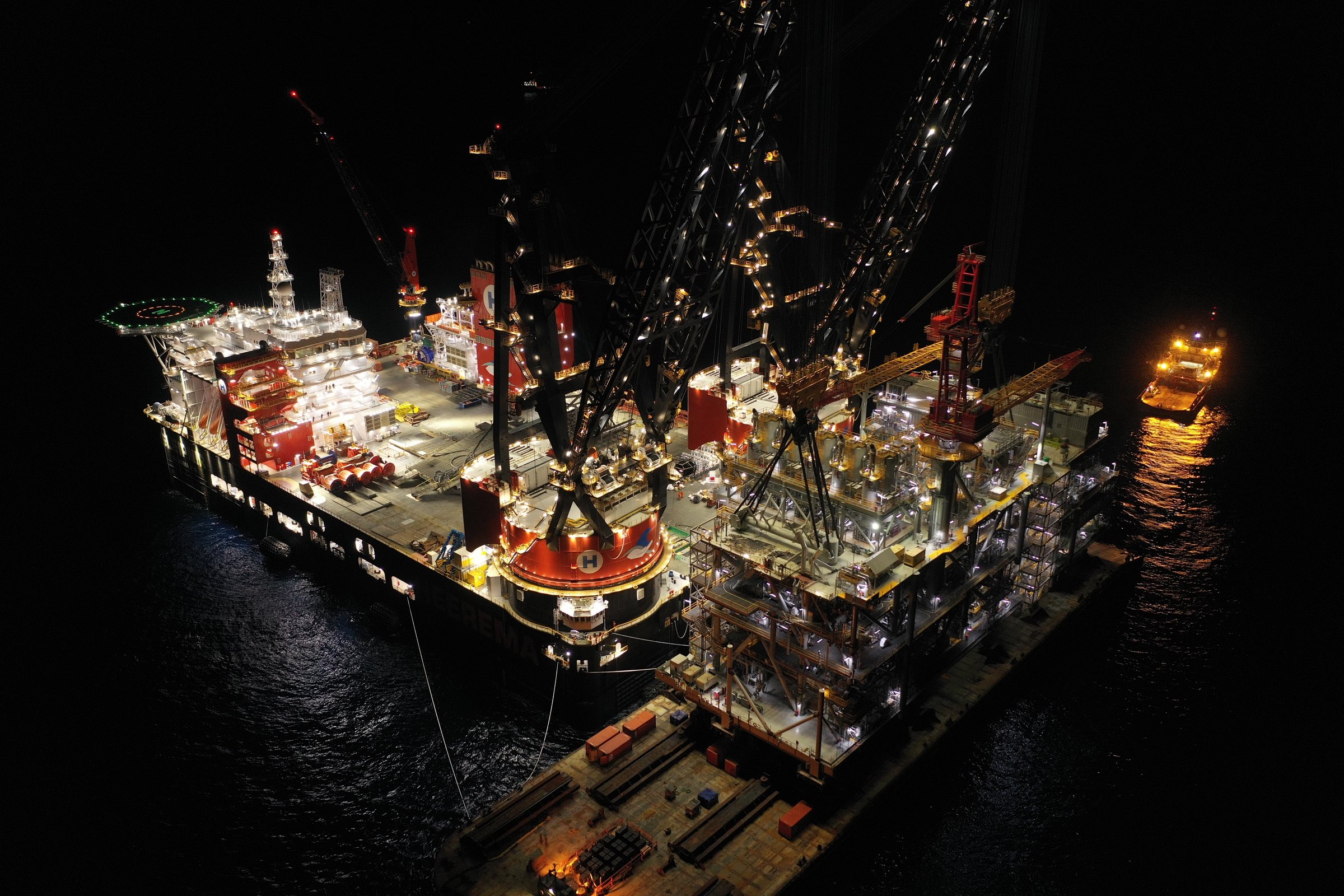

Sleipnir installing Leviathan platform (5)

Let’s talk about your challenge.

Want to discuss how our solutions can help your project? Get in touch with one of our experts!
